Automating Change Orders and Budget Snapshots in Procore

Change orders are a normal part of construction.
A project scope changes. A material price increases. A client requests additional work. A design is modified.
But the administrative work that follows can become surprisingly complicated.
A change event may need to be reviewed by the project team, approved by the appropriate stakeholders, reflected in project financials, communicated to accounting, and included in budget reporting.
When these steps are handled manually, someone is often waiting for information from another team.
A project manager may be waiting for accounting. Accounting may be waiting for an approval. A controller may be working from a budget that does not yet reflect the latest approved change.
This is where Procore change order automation can help.
Instead of relying on employees to repeatedly check systems, export information, update spreadsheets, and send notifications, selected parts of the change-order workflow can be automated.
The goal is not to automate every decision.
The goal is to automate the repetitive steps that happen after the required business decision has already been made.
What Is a Change Order in Construction?
A change order is a written amendment to a construction contract that changes the agreed scope, price, or schedule. It records what is changing and why, along with the cost and time impact, and it takes effect once the required parties approve it.
In Procore, the process usually starts with a change event: a record of a potential change. If the change affects contract value, it moves into a change order request and then into an approved change order, either on the prime contract with the owner or on a commitment with a subcontractor or supplier. Each of those steps carries financial data that accounting eventually needs, which is why change orders are one of the most common reasons to integrate Procore with an accounting system.
Why Change Orders Create Administrative Work
Change orders can affect more than one part of a construction company's workflow.
A project team may manage the change in Procore while the accounting team needs the financial information in its accounting or ERP system.
That creates a potential handoff.
For example:
- A change event is created.
- The financial impact is reviewed.
- The change is approved.
- Accounting needs the approved information.
- Budget information needs to be updated.
- Project stakeholders need to know about the financial impact.
When each step depends on someone manually moving information, delays can occur.
The problem becomes more noticeable when a company manages multiple projects and a high volume of change events.
A process that takes only a few minutes for one change can become several hours of administrative work over an entire week.
What Procore Exposes for Change Events
Procore provides API access that can allow approved applications and integrations to work with data from Procore.
For a change-order automation workflow, the relevant information can include change event records, financial information associated with the change, and approval-related information, depending on the specific Procore tools, API endpoints, permissions, and integration design.
For additional information, readers can review the official Procore Change Events documentation.
The exact data available should always be confirmed against the current Procore API documentation and the specific Procore configuration being used.
Change Event Records
A change event represents a potential change to the project's scope, cost, or other relevant project information.
Through an integration, relevant change-event information can potentially be retrieved and processed without requiring someone to manually copy it into another system.
Cost Impact
Change events can contain financial information that may be important when evaluating their impact on the project.
An integration can use relevant financial data as part of an automated workflow, depending on the fields and endpoints included in the implementation.
Approval Status
Approval information can be important because an integration should not necessarily send every proposed change directly into an accounting system.
A workflow can be designed to take action when a change reaches a defined status, such as an approved state.
The exact trigger should be based on the company's business rules.
What Does Change Order Automation Look Like?
Automation can take several forms.
The important distinction is between automating information movement and automating business decisions.
A system should not approve a change order simply because an API can detect it.
Instead, the approval should remain with the people responsible for the project and financial decision.
Once the required approval has occurred, automation can handle repetitive downstream tasks.
Automatically Push Approved Change Orders to Accounting
One common workflow is to transfer approved change-order information from Procore to the company's accounting or ERP system.
Instead of an accounting employee manually re-entering the approved information, the integration can detect the defined approval status and send the relevant data according to the agreed mapping.
For example:
The integration can then record the synchronization result so the team can determine whether the transfer succeeded or requires attention.
The exact records and fields transferred depend on the accounting system and the company's requirements.
Automatically Generate Budget Snapshots
Budget snapshots can provide a way to preserve a view of project financial information at a particular point in time.
A workflow can be designed to trigger a budget snapshot when a defined change-order approval occurs.
For example:
This can give project and financial teams a clearer record of the budget position associated with an important project change.
The exact snapshot process depends on how the company's budget reporting is structured.
Send Cost-Overrun Alerts
Automation can also be used to notify project or financial teams when defined cost thresholds are reached.
For example, a workflow could check whether a change causes a project's projected cost to exceed a predefined threshold.
If the condition is met, the system could send an email or Slack notification to the appropriate team.
The workflow might look like:
The threshold should be defined by the business rather than hard-coded as a universal rule.
A $10,000 change may be significant for one project and relatively minor for another.

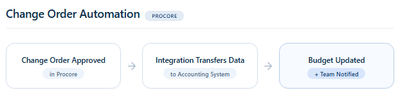

Procore Change Order Automation Workflow

Change Order Approved in Procore
↓
Integration Transfers Data to Accounting System
↓
Budget Updated + Team Notified
A Simple Example of the Workflow
Imagine a contractor where approved change orders need to be manually reconciled with accounting every Friday.
The project manager reviews the changes in Procore.
The controller then compares the approved changes against accounting records.
If something is missing or does not match, the team investigates the discrepancy.
The reconciliation takes approximately four hours every week.
A possible automated workflow could instead be:
Step 1: Change event is created in Procore.
Step 2: Project team reviews the change.
Step 3: Required approval is completed.
Step 4: Integration detects the approved status.
Step 5: Relevant change-order information is mapped to the accounting system.
Step 6: Budget information is processed according to the company's rules.
Step 7: A notification is sent if a defined cost threshold is exceeded.
Step 8: The synchronization result is logged.
This does not remove the project manager or controller from the process.
It removes repetitive information-transfer work around the process.
What Four Hours a Week Actually Costs
Go back to the four-hour-a-week scenario above. That is a hypothetical number, not a specific client's reported result, but it is a realistic one for a team doing manual Friday reconciliation, and it is useful for seeing how a small weekly task adds up.
In that scenario, once the workflow is automated, the recurring reconciliation work goes away. The team still reviews exceptions and approves changes. They stop re-checking entries by hand every week.
The actual time savings from Procore change order automation will depend on factors such as project volume, number of change events, accounting processes, system configuration, and the scope of the integration.
However, the scenario illustrates an important point:
Even a small recurring manual process can create a meaningful annual cost.
Four hours per week represents approximately:
4 × 52 = 208 hours per year.
That is more than 200 hours of employee time that could potentially be redirected toward project analysis, financial review, forecasting, or other higher-value activities.
What You Need to Set This Up
Automating a change-order workflow requires more than simply connecting Procore to another system.
The integration needs to understand both the technical systems and the business process.
A Developer Familiar With the Procore API
The developer or integration team should understand how to work with the Procore API, authentication, available endpoints, permissions, data structures, and API limitations.
They also need to understand how information should be processed once it is retrieved.
For technical reference, the Procore Developer Portal provides documentation and resources for developers working with Procore APIs.
Knowledge of Your Accounting System
The integration team also needs to understand the accounting or ERP system receiving the information.
This includes knowing which records should be created or updated, which fields are required, and how the accounting system represents relevant project financial information.
Clear Business Rules
Before development begins, the company should define the rules that determine when automation should occur.
For example:
- Which change events should be synchronized?
- What status triggers the workflow?
- Which fields should move to accounting?
- Which system is the source of truth?
- When should a budget snapshot be created?
- What cost threshold should trigger an alert?
- Who should receive failure notifications?
These decisions are just as important as the technical connection.
Field Mapping Is a Critical Step
Procore and an accounting system may use different names or structures for similar information.
For example, one system may identify a project using one identifier while another uses a different job number.
The integration needs to know how those records correspond.
This process is called field mapping.
A basic example might look like this:
| Procore Information | Accounting System Information | Purpose |
|---|---|---|
| Project | Job | Connect the project to the accounting record |
| Change Event | Change Order | Transfer the approved change |
| Cost Code | Cost Code | Maintain cost classification |
| Amount | Change Amount | Transfer financial impact |
| Approval Status | Workflow Status | Determine whether processing should occur |
| Description | Change Description | Preserve useful context |
The actual fields will vary depending on the company's systems and requirements.
A mapping table like this should be finalized before production deployment.
Error Handling Matters
Automation does not mean errors disappear.
A change order could fail to synchronize because of a missing field, invalid mapping, authentication issue, duplicate record, or problem in the receiving accounting system.
That is why an integration should have an error-handling process.
A useful workflow can:
- Record synchronization attempts
- Identify failed records
- Provide an understandable error message
- Notify the appropriate person
- Prevent duplicate processing where necessary
- Allow failed records to be reviewed and corrected
The objective is to make failures visible rather than allowing them to become hidden reconciliation problems.
Testing Before Going Live
A change-order integration should be tested before it is introduced into a production workflow.
Testing can begin in an appropriate sandbox or test environment where possible.
The team can then test scenarios such as:
- Approved change order
- Unapproved change order
- Missing required field
- Invalid cost code
- Duplicate record
- Cost threshold exceeded
- Accounting-system failure
- Successful synchronization
Testing these scenarios helps confirm that the integration behaves according to the company's business rules.
What Automation Does Not Do by Itself
An API is a connection mechanism.
It does not automatically understand your company's business process.
Simply having access to Procore data does not mean the system knows:
- Which fields should be transferred
- When information should move
- Which system is the source of truth
- How records should be mapped
- What should happen when synchronization fails
- Who should receive alerts
- Which financial thresholds matter
Those decisions require an integration design.
This is why a successful Procore change order workflow involves both technical development and business-process planning.
The Difference Between an API and an Integration
It is useful to separate these two concepts.
The API provides a way for software to communicate with Procore.
The integration is the complete workflow built around that communication.
Think of the API as a doorway.
The integration decides:
Who goes through the doorway, what they carry, where they go, and what happens when they arrive.
For a construction company, that could mean taking an approved change event from Procore, mapping it to an accounting record, updating the relevant financial information, checking a cost threshold, and sending a notification.
The API makes communication possible.
The integration makes that communication useful to the business.
When Procore Change Order Automation Makes Sense
Automation is worth evaluating when change-order administration has become repetitive and measurable.
Signs may include:
- Weekly manual reconciliation
- Employees re-entering approved change information
- Spreadsheets used to compare systems
- Delays between project approval and accounting updates
- Frequent discrepancies
- Manual budget updates
- Repeated email or Slack notifications
- Difficulty identifying which changes require financial attention
These signs do not automatically mean that automation is the right solution.
The next step is to measure the current process.
Ask:
How many hours does the team spend on it each week?
How many change events are processed?
Where do errors occur?
How quickly does approved information reach accounting?
What happens when information does not match?
The answers provide a baseline for evaluating potential ROI.
The Business Value of Automating Change Orders
The value of automation is not limited to eliminating data entry.
It can also help create a more consistent workflow.
When the same business rules are applied each time, teams may spend less time checking whether routine steps were completed.
Automation can also reduce the delay between an approved project change and the downstream financial processes that depend on that information.
For controllers and project managers, this can make financial information easier to monitor without requiring employees to repeatedly move information between systems.
The actual benefit will depend on the company's workflow and implementation.
FAQs
What's the difference between a change event and a change order in Procore?
A change event is a record of a potential change. If it affects contract value, it moves into a change order request and then into an approved change order, either on the prime contract with the owner or on a commitment with a subcontractor or supplier.
What should actually be automated in a change order workflow?
Automating information movement, not automating business decisions. The approval itself stays with the people responsible for the project and financial decision; automation handles the repetitive downstream tasks once that approval has already happened.
What can Procore change order automation actually do?
Automatically push approved change orders to the accounting system, generate budget snapshots tied to specific approval events, and send cost-overrun alerts when a defined threshold is exceeded, logging the result so failures stay visible.
How much does a weekly manual change-order reconciliation actually cost?
A weekly manual reconciliation scenario of four hours a week adds up to roughly 208 hours a year. That's a hypothetical but realistic figure for a team doing manual Friday reconciliation, not a specific client's reported result.
What does field mapping mean in a change order integration?
Connecting how Procore and an accounting system represent the same information differently, for example matching a Procore "Project" to an accounting "Job," or a "Change Event" to a "Change Order," so records correspond correctly during synchronization.
What happens when a change order fails to synchronize?
A properly designed integration records the synchronization attempt, identifies the failed record, provides an understandable error message, and notifies the right person, rather than letting the failure become a hidden reconciliation problem.
Final Takeaway
Change orders can affect project scope, cost, budgets, accounting records, and financial reporting.
When teams manage these connections manually, even a relatively small weekly reconciliation process can consume significant employee time over the course of a year.
A properly designed integration can potentially automate selected steps, such as:
- Moving approved change orders to accounting
- Creating budget snapshots based on defined events
- Checking cost thresholds
- Sending email or Slack alerts
- Recording synchronization results
- Identifying failed transactions
But the API itself is only one part of the solution.
The real value comes from combining the API with clear field mappings, business rules, approval triggers, error handling, testing, and an understanding of how the company actually operates.
At Aishco Solutions, the focus is on understanding that workflow first and then determining how technology can reduce unnecessary manual work.
For construction companies evaluating Procore budget automation or Procore change order automation, the starting point is simple:
Measure the manual process, identify the repetitive steps, and determine whether automating them can create enough value to justify the investment.
