Modular Construction and Software: What Changes When Timelines Shrink

Modular construction changes more than where a building is assembled. It changes how project teams plan, track, document, and coordinate work, and what they need from modular construction software.
When major portions of a project move into a factory, activities that traditionally happen one after another on a jobsite can happen simultaneously. While site preparation is underway, modules may already be fabricated, inspected, and prepared for transportation.
This compressed workflow can reduce project timelines significantly. McKinsey estimates that modular construction can accelerate project timelines by 20 to 50 percent, depending on project type, design standardization, site conditions, and how much work is moved offsite.
But faster construction creates a new operational challenge: software workflows designed around traditional construction schedules may not provide enough visibility for modular projects.
For project managers and operations teams moving from stick-built construction to offsite work, the question is whether existing systems can handle procurement, fabrication, quality control, transportation, and site work happening together.
Why Traditional Construction Software Workflows Can Struggle With Modular Timelines
Traditional construction schedules often follow a relatively sequential pattern.
Design is completed, materials are ordered, construction begins, and different trades progress through the site according to the project schedule.
Modular construction introduces much more overlap.
A project may have foundation work happening onsite while modules are being fabricated in a factory. At the same time, materials for later assemblies may already need to be purchased, inspected, and delivered to the manufacturing facility.
This creates a much smaller margin for delays.
A two-week procurement delay in a traditional project may affect activities several weeks later. In a modular project, that same delay can stop factory production because the required component is not available when an assembly reaches the production line.
The issue is therefore not just speed. It is dependency.
When timelines shrink, project teams need software that can show how one activity affects others across different locations.
A project management platform may track the overall schedule, but modular projects often require additional information about:
- Factory production status
- Module-level progress
- Material availability
- Quality inspections
- Transportation readiness
- Site readiness
- Factory-to-site handoffs
- Documentation and approvals
Without these connections, teams may have data in multiple systems but still lack a reliable view of what is happening.
Procurement Has to Move Earlier
One of the biggest operational changes in modular construction is procurement timing.
In traditional construction, teams may be able to purchase certain materials closer to when they are needed onsite. Modular construction reduces that flexibility.
Factory production depends on having materials available at specific stages of manufacturing.
For example, if an electrical component is required before a module can move to its next production stage, procurement teams cannot wait until the module is nearly complete.
The material needs to be available when production reaches that point.
A modular construction software workflow should ideally provide visibility into:
| Procurement Requirement | Operational Need |
|---|---|
| Material status | Know what has been ordered, shipped, received, or delayed |
| Required-by date | Connect procurement deadlines to production schedules |
| Supplier information | Identify who is responsible for each component |
| Material-to-module relationship | Know which module or assembly requires the material |
| Delay alerts | Identify potential production impacts early |
This creates a shift from asking, "Has the material been ordered?" to asking, "Will the material be available before the production activity that depends on it?"
That distinction becomes increasingly important as schedules become compressed.
Factory-to-Site Handoffs Become a Critical Workflow
A modular project has at least two major operating environments: the factory and the construction site.
Information needs to move between both.
A module may be completed in the factory, inspected, documented, approved for transportation, shipped, received onsite, and then installed.
Each step creates a potential handoff.
If the factory team marks a module as complete but the site team does not have the same information, coordination problems can occur.
The site may not be ready.
Transportation may not be scheduled.
Required documentation may be missing.
A module may arrive before the installation crew or equipment is available.
These problems can happen when systems do not connect the information required by different teams.
For this reason, modular construction project management needs to treat the module as a trackable project object rather than simply another line item in a schedule.
Teams should be able to associate information such as:
- Module identification
- Factory production status
- Quality inspection status
- Required documentation
- Shipping status
- Delivery date
- Site readiness
- Installation status
- Outstanding issues
This gives project managers a clearer chain of custody from factory production to final installation.
Quality Documentation Moves Into the Factory
Quality management also changes when construction moves offsite.
On a traditional project, many inspections happen directly at the jobsite. With modular construction, much of the work may be completed before the module reaches the project location.
That means quality documentation needs to travel with the work.
Inspection records, photographs, checklists, test results, approvals, and nonconformance information may need to be associated with a specific module or assembly.
A project team should not have to search through separate folders, spreadsheets, emails, and factory systems to determine whether a module passed inspection.
Instead, quality information should be connected to the relevant module and accessible to the teams responsible for the next stage.
If a recurring issue appears across multiple units, teams need a way to identify the pattern quickly and determine whether corrective action is required.
The faster the project moves, the more expensive it can become to discover a quality issue late in the process.
Where Modular Construction Software Gaps Appear
Many construction companies already use software for project management, scheduling, procurement, document management, accounting, or field operations.
The problem is that these systems may not have been designed around modular workflows.
One platform may contain project schedules.
Another may manage procurement.
A factory system may track production.
A transportation provider may maintain delivery information.
A quality system may store inspection records.
The information exists, but it may not be connected.
For example, a project management platform could show that a module is scheduled for installation on Friday. But if the factory system shows that production is delayed and transportation has not been scheduled, the project schedule alone does not provide enough operational context.
Integration can connect these systems so important status changes flow between them.
This is where offsite construction technology and software integration can help create better visibility across the workflow.

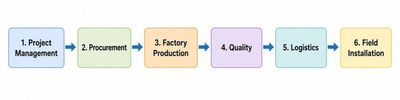

A modular construction technology environment might connect:

Instead of requiring teams to manually update multiple systems, integrations can synchronize relevant information and reduce duplicate data entry.
Integration Can Close the Visibility Gap
The goal of integration is not necessarily to replace every existing system.
In many cases, companies already have software that works well for individual parts of the construction process. The missing piece is the connection between those systems.
An integration strategy can focus on workflows where delays or duplicate work create the most operational risk.
For example, when a factory marks a module as production-complete, an integration could pass that status to the project management system.
When quality documentation is approved, the relevant status could become available to the project team.
When transportation is confirmed, expected delivery information could be connected to the site schedule.
This creates a more connected workflow without forcing every team to abandon the tools they already use.
The exact integration approach will depend on the systems involved, available APIs, data structures, and project requirements.
But the principle is straightforward: critical information should move with the work.
What Project Teams Should Evaluate Before Scaling Modular Work
Companies moving into modular construction can start by mapping the complete information flow.
Ask:
- Where does each module get created in the system?
- Where is its production status recorded?
- How is procurement connected to production?
- Where are factory inspections stored?
- How does the site team know a module is ready?
- How is transportation status communicated?
- Which systems require the same information to be entered manually?
- What happens when a module is delayed or fails inspection?
The answers can reveal where existing software supports the modular workflow and where integration work may be required.
This assessment is especially valuable before a company scales modular production across multiple projects.
A workflow that works manually for five modules may become difficult to manage when the same process involves hundreds of units across multiple projects and locations.
FAQs
How much can modular construction accelerate project timelines?
McKinsey estimates modular construction can accelerate project timelines by 20 to 50 percent, depending on project type, design standardization, site conditions, and how much of the work moves offsite into the factory.
Why do traditional construction software workflows struggle with modular timelines?
Traditional schedules follow a relatively sequential pattern, but modular construction overlaps fabrication, procurement, and site work at the same time. A delay that would be minor on a traditional project can stop factory production entirely on a modular one.
Why does procurement need to happen earlier in modular construction?
Factory production depends on materials being available at specific manufacturing stages, not just before installation. The question shifts from "has the material been ordered" to "will the material be available before the production activity that depends on it."
What is a factory-to-site handoff in modular construction?
The point where information needs to move between the factory and the jobsite as a module is completed, inspected, approved, shipped, and installed. If the factory marks a module complete but the site team doesn't have that same information, coordination problems follow.
Why does quality documentation need special handling in modular projects?
Much of the inspection work happens before the module ever reaches the project site, so inspection records, photos, and approvals need to travel with the module and stay accessible to the teams responsible for the next stage, rather than sitting scattered across separate systems.
Does a modular construction company need to replace its existing software?
Not necessarily. Connecting the systems already in place, project management, factory production, procurement, and quality tools, so critical status changes flow between them automatically, is usually the faster path instead of requiring every team to start over.
Modular Construction Requires Connected Operations
The biggest software change in modular construction is not simply the need for another project management platform.
It is the need for connected visibility across a faster and more distributed workflow.
Procurement needs to align with factory production. Quality documentation needs to follow modules beyond the factory. Transportation needs to connect with site readiness. Project managers need visibility into events happening away from the jobsite.
As modular construction continues to gain attention in data centers and other high-growth sectors, connected software workflows will become increasingly important.
Companies that already have construction software in place do not necessarily need to start over. The opportunity may be to connect the systems they already use and build workflows around the way modular projects actually operate.
If your organization is moving toward modular or offsite construction, the first step is understanding where information gets stuck between the factory and the field.
